By BM
With just two years until Uganda co-hosts the Africa Cup of Nations (AFCON) 2027, Hoima City is firmly in the spotlight.
On Monday, 126 new photos were released in the 58th weekly report documenting the progress of the flagship Hoima City Stadium and the images tell a compelling story of rapid transformation and readiness.
Through the leadership at National Council of Sports (NCS), the Janet Museveni-led Ministry of Education & Sports is overseeing this gigantic construction project on behalf of the GoU.

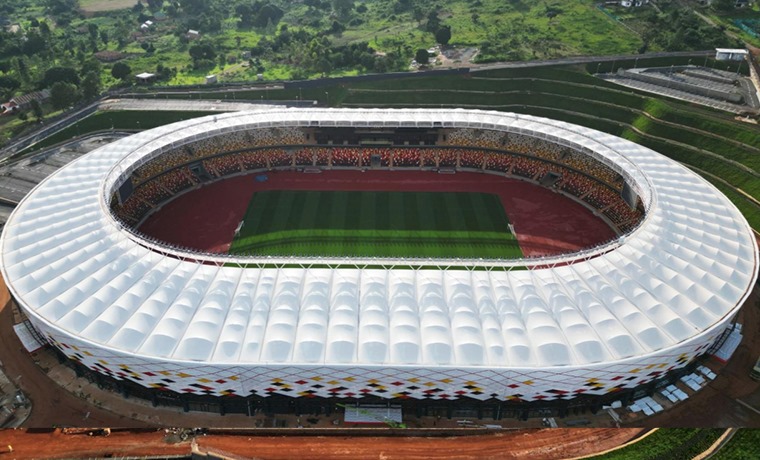

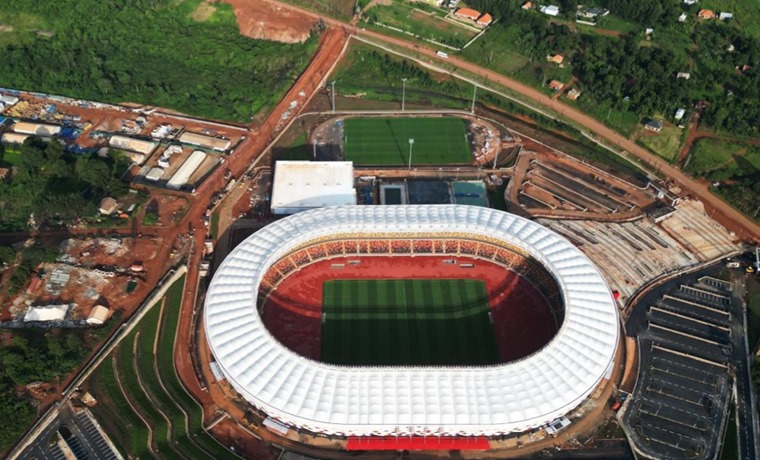

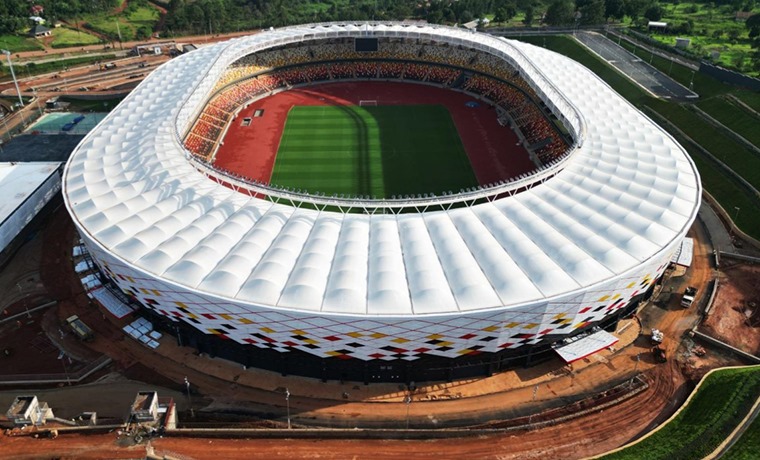

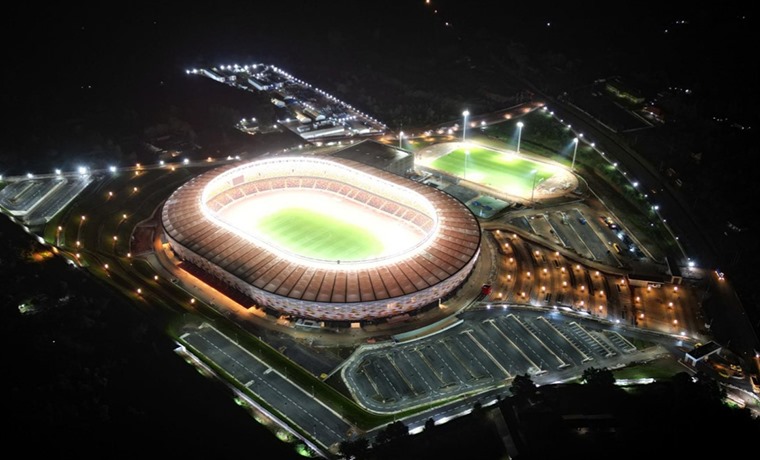

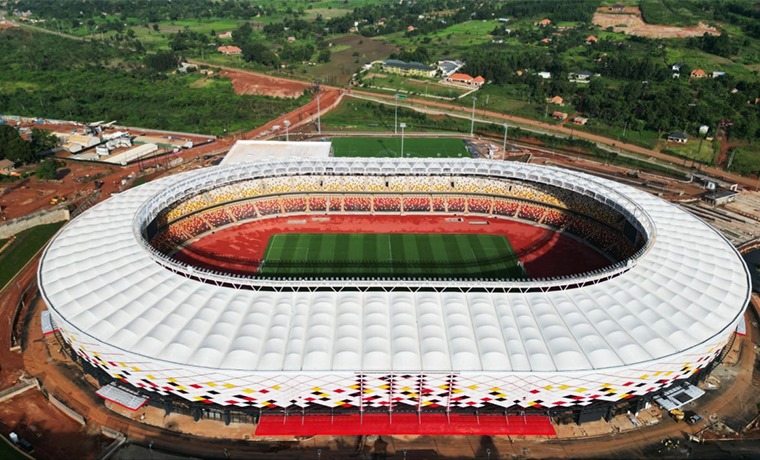

The newly released photographs provide a compelling visual update; beginning with front and aerial views of the 20,000-seater stadium by day and night.

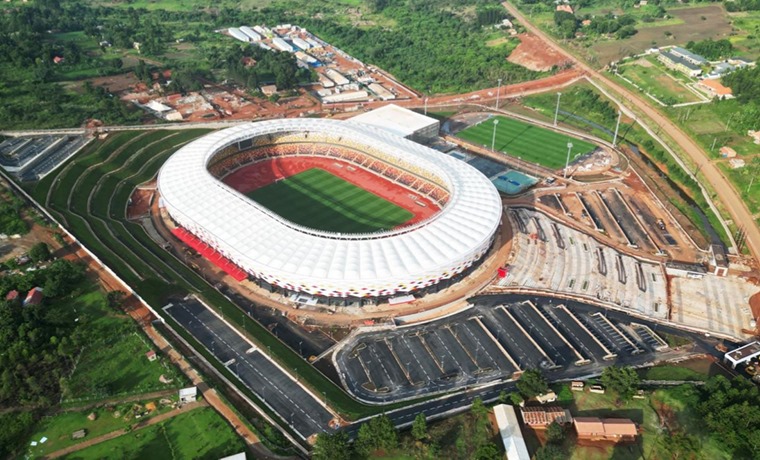

Also featured are top-down comparisons from September 15th to 22nd 2025; showing visible changes in the structure and landscape.
The report offers a detailed look into both the exterior and interior works. Interior shots reveal substantial progress: fixed furniture installation at VIP and press entrances, elevators nearing final installation, wallpaper designs being applied and loose furniture arriving.
Vinyl flooring, door fittings, PVC skirting, signage, socket installations and even tactical boards for dressing rooms are all shown nearing completion.
Among other highlights are the hospitality lounge, the AC electrical room, extensive painting works and installation of FFE (furniture, fixtures and equipment).

The team bench and main pitch now present a near-final look, while images of the basement, mini area and outdoor courts show ongoing leveling and surfacing — particularly at the volleyball court.
Roadworks and auxiliary infrastructure are also progressing. The latest photographic illustration also documents stone base application on Access Road 4, road markings in parking zones one and two and the gatehouse’s aluminum framing and glass installation.
Even finer details like acrylic sinks and toilet cubicles in the ticket office are already being installed.
State Minister for Sports Peter Ogwang recently appreciated the contractor (M/S Suuma) for advancing ahead of schedule. “The project, initially set for completion in December 2025, is now likely to be handed over by October,” predicted Minister Ogwang.
Project Manager Murat Altun also confirmed that the main stadium is 98% complete, with the overall project standing at 89%. He credited the Ministry of Energy for facilitating a special power line to support the site.
The $129mn stadium project, sitting on a 34-acre piece of land, will host football, rugby and athletics. With AFCON 2027 on the horizon, Hoima City is not just building a stadium — it’s building history. (For comments on this story, get back to us on 0705579994 [WhatsApp line], 0779411734 & 041 4674611 or email us at mulengeranews@gmail.com).
